Mahira Homes 63A: -  Construction Work Status (February 2023)

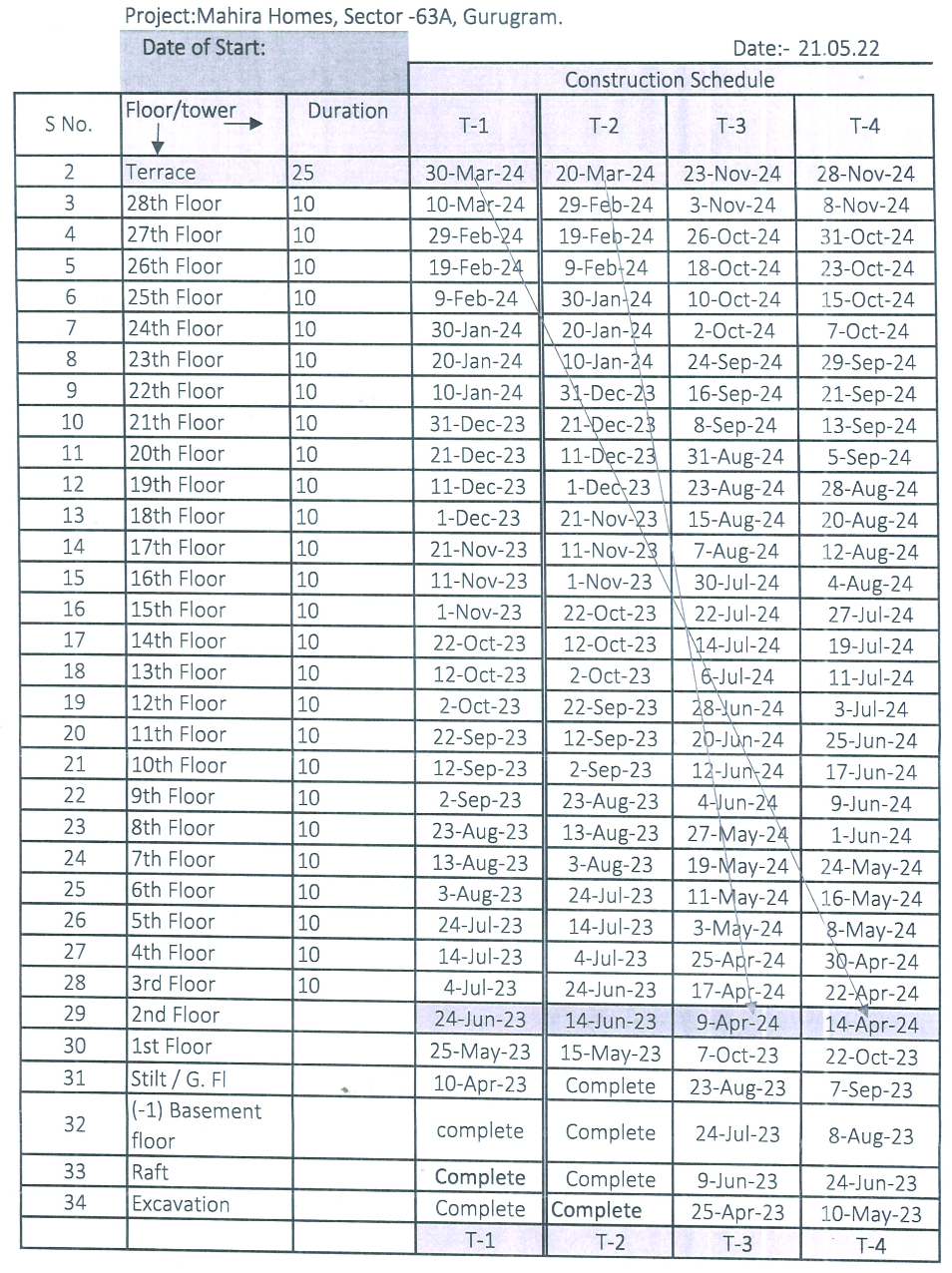

S.No. Towers Construction status

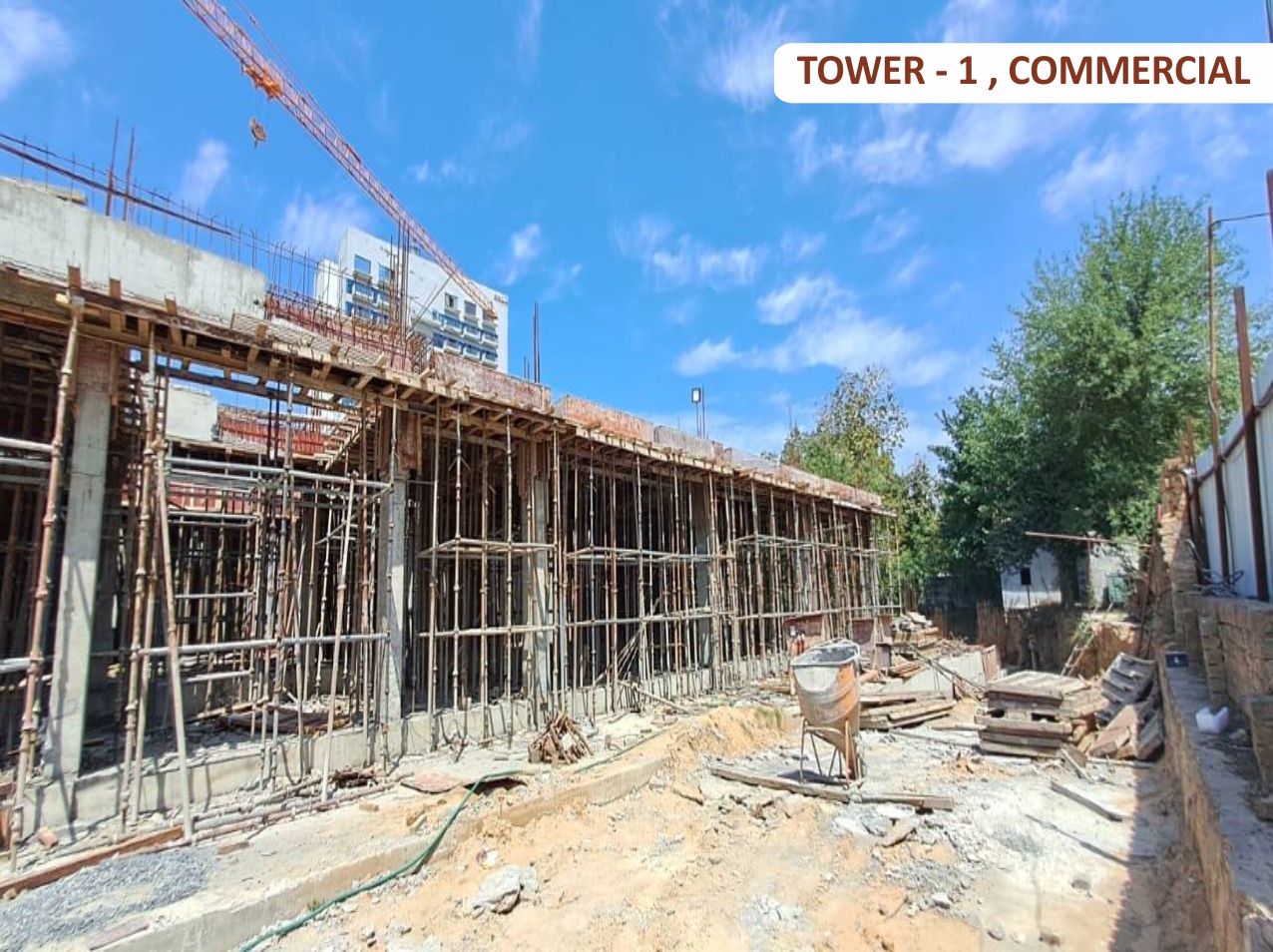

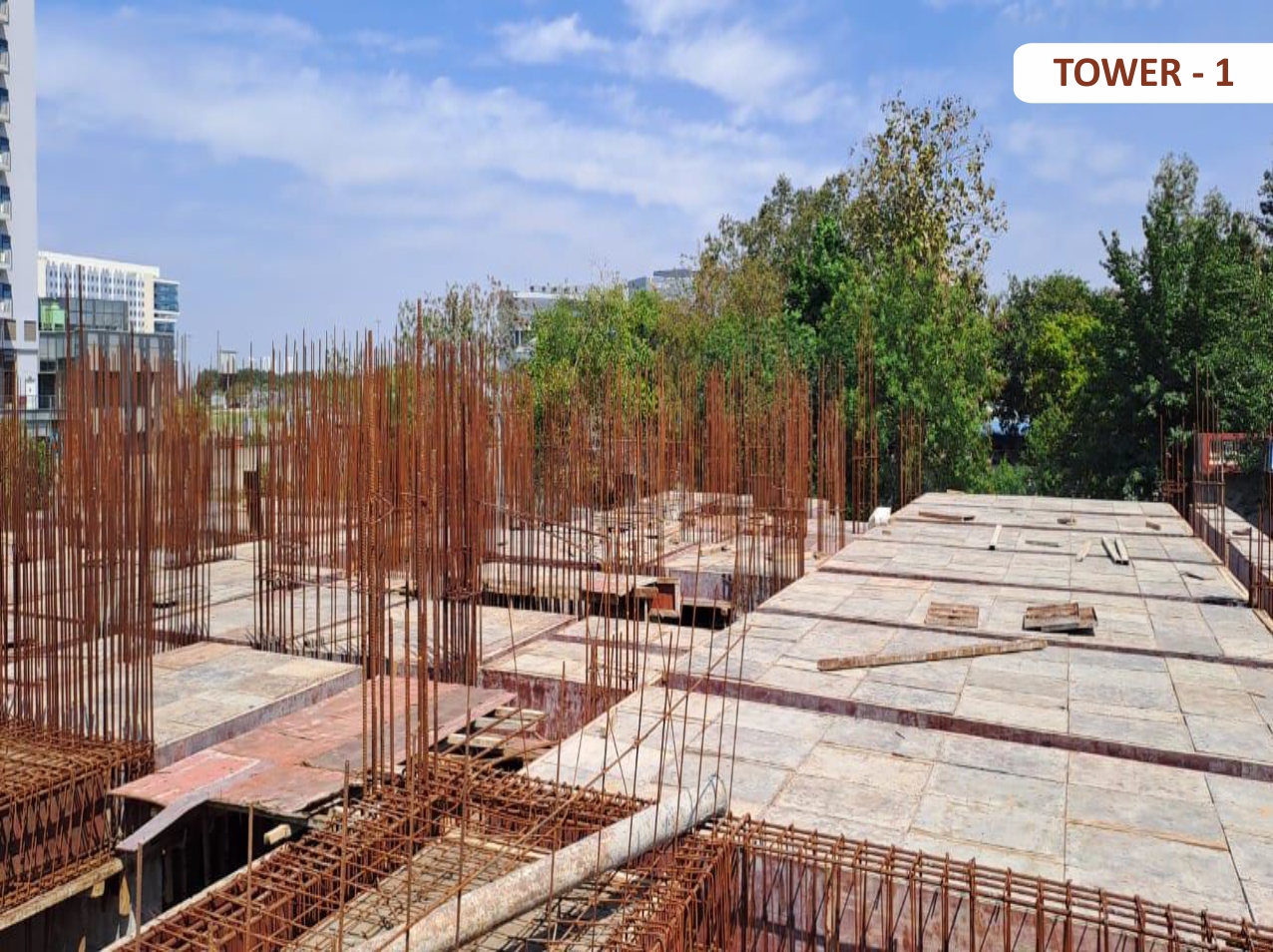

1 Tower 1 The lower basement slab is completed and the upper basement slab is 90 % completed rest in progress

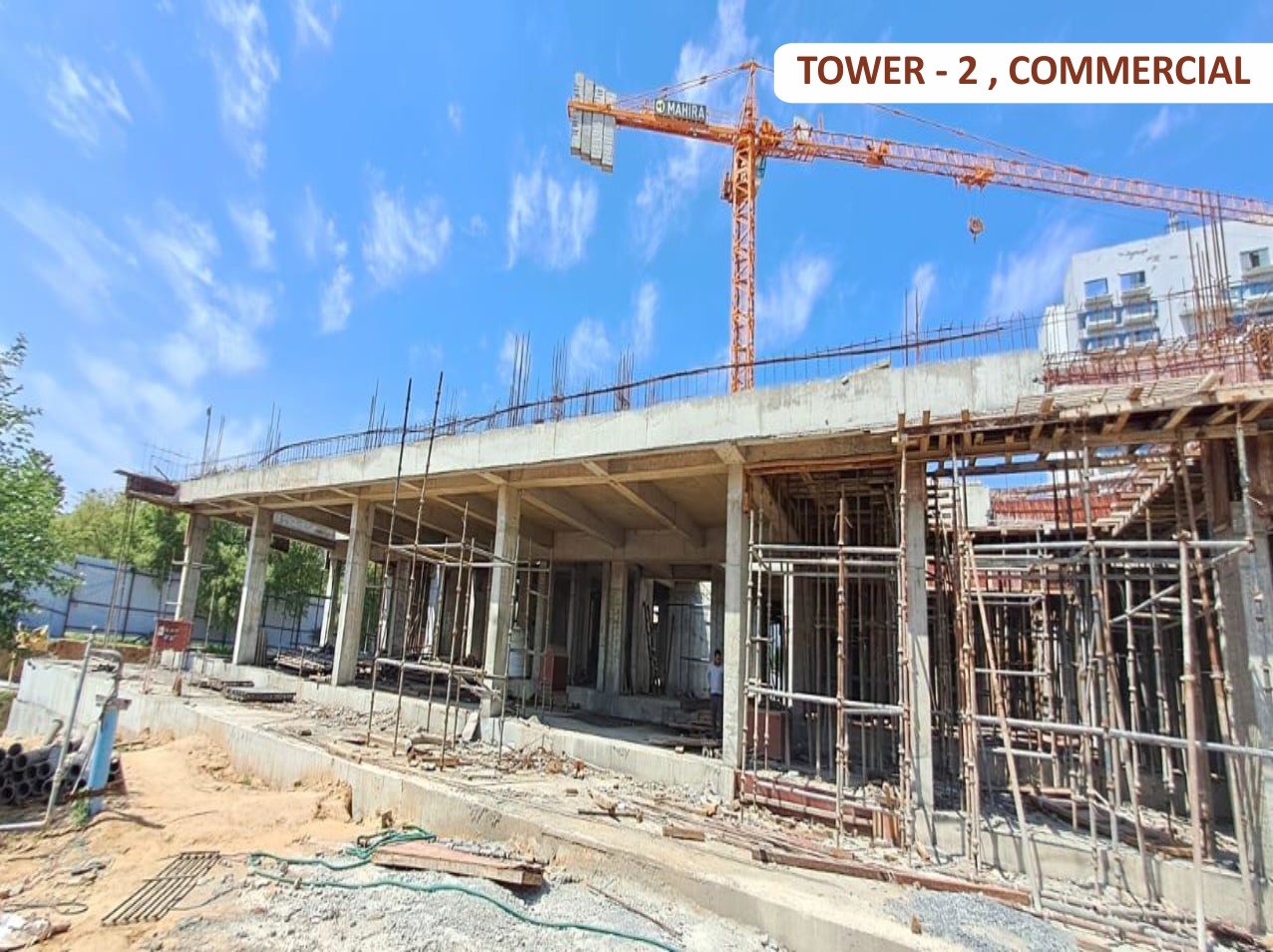

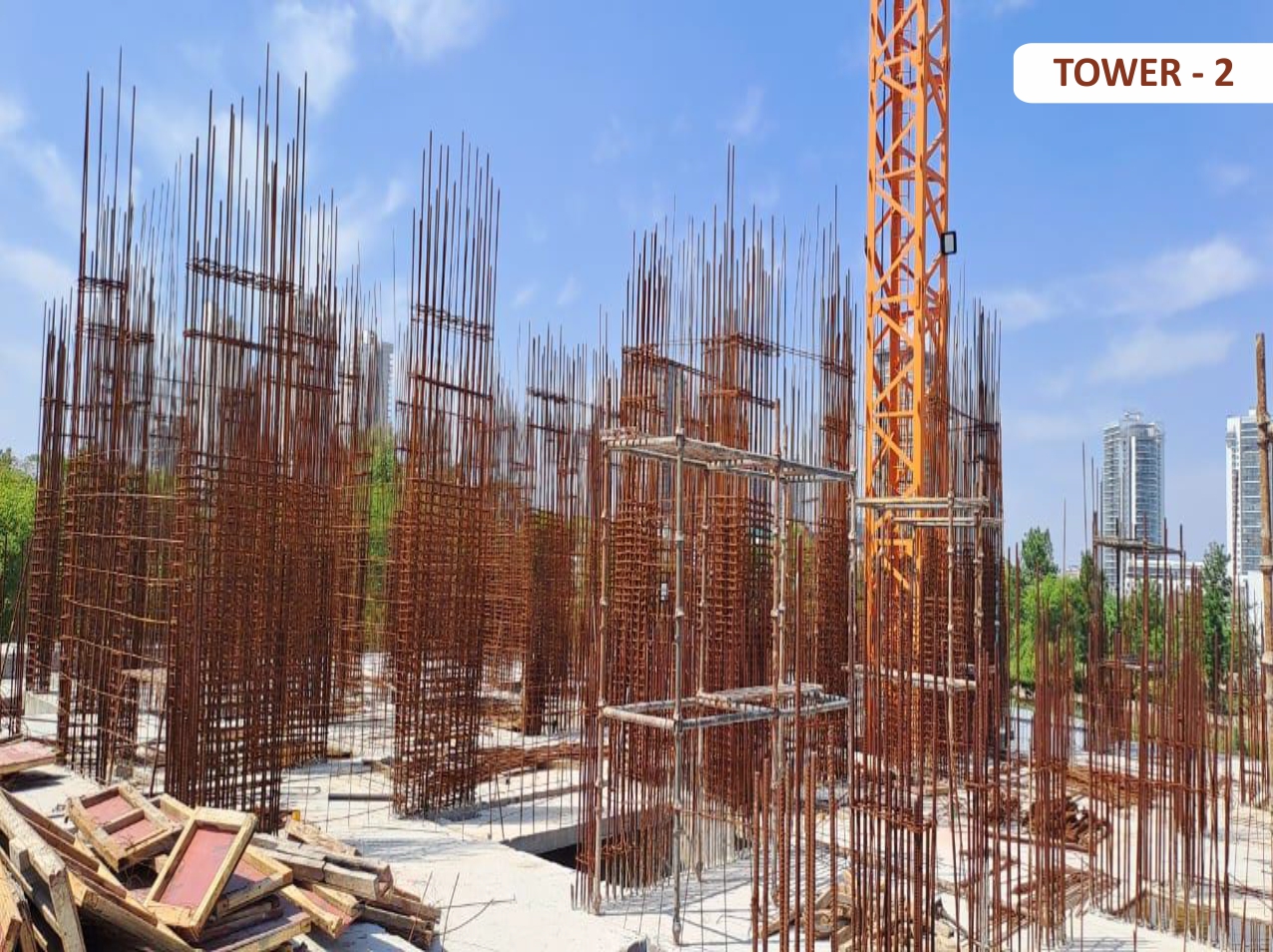

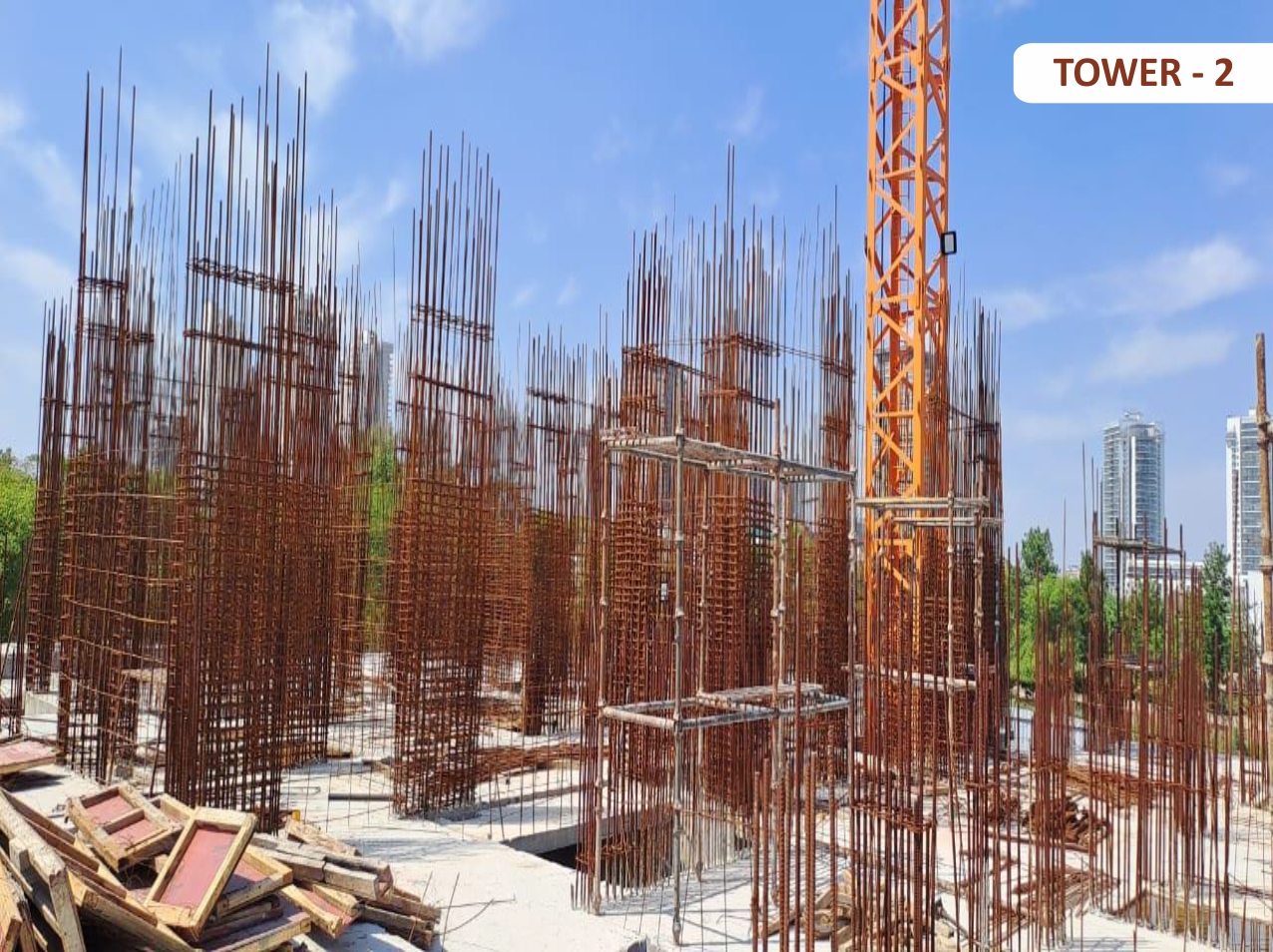

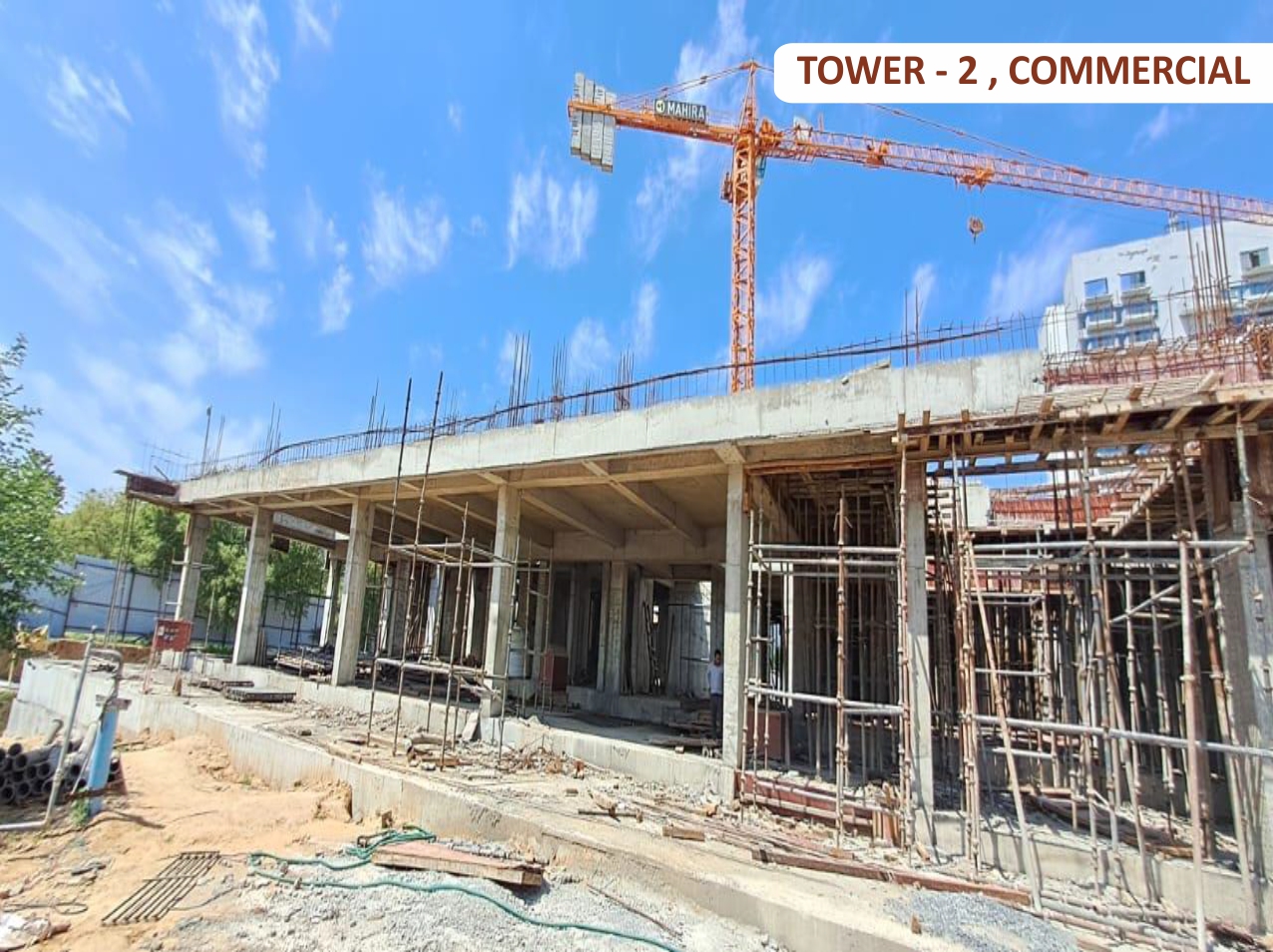

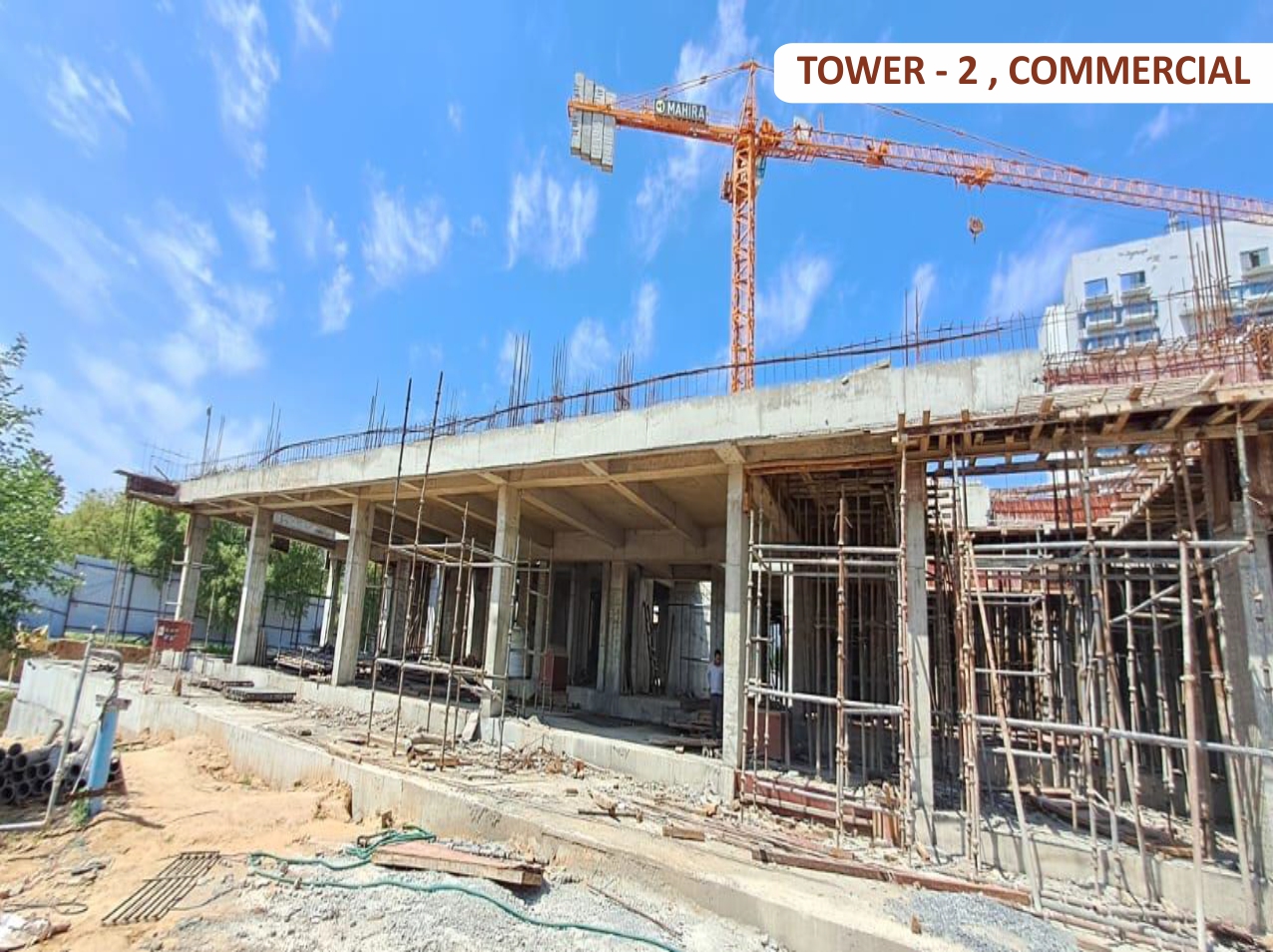

2 Tower 2 Stilt floor roof shuttering is 70% completed

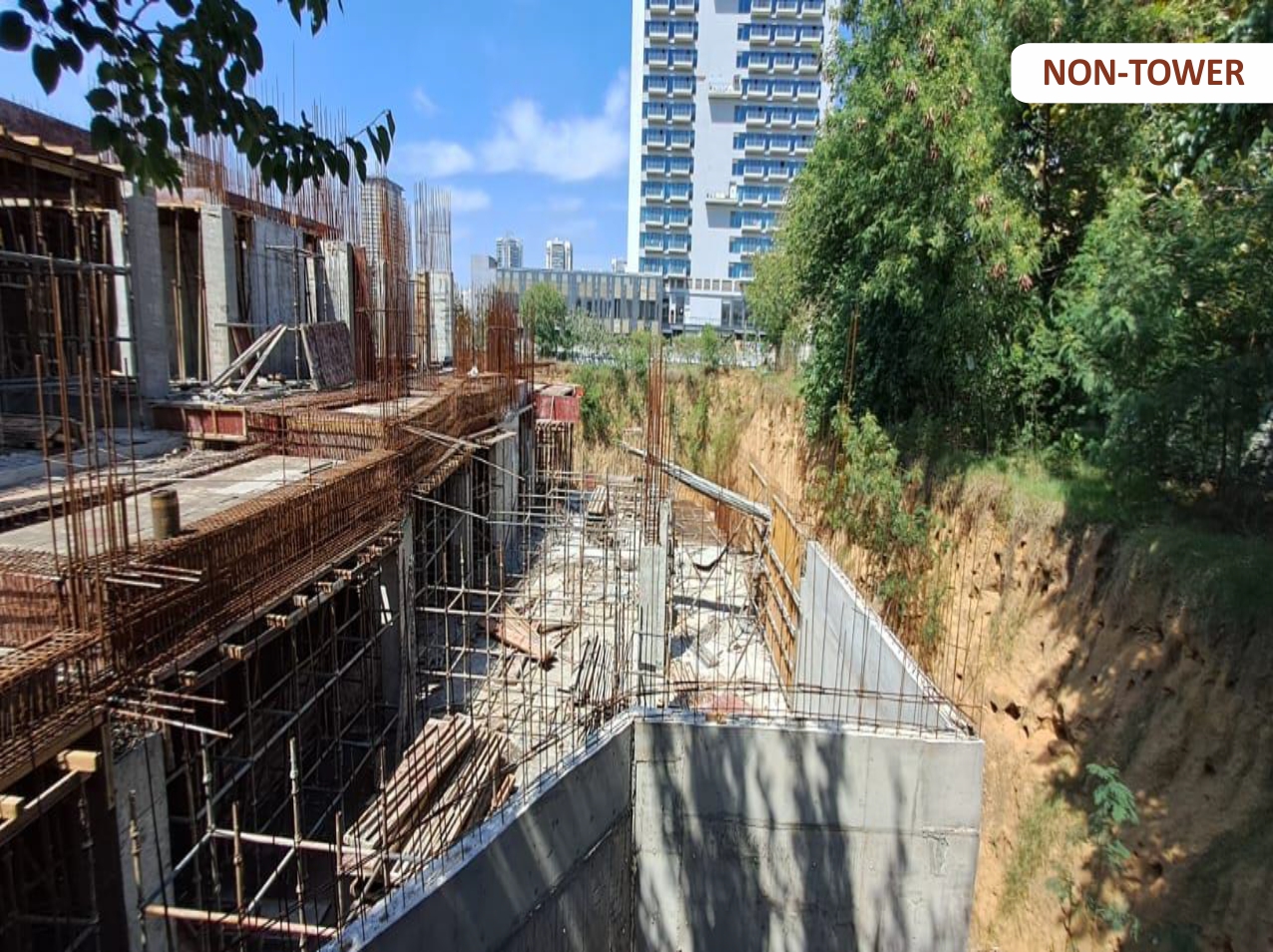

3 Non-Tower Lower and Upper floors are 25% completed and rest in progress
4 Tower 3 Basement Excavation in progress
